They had an older (1970’s) ranch house on the west side of the Denver metro area. The kitchen had yellowed sheet vinyl which was starting to lift around the patio slider. The hall bathroom had 4 1/4″ square wall tile which started to get soft around the tub and a floor of 1″ mosaic tile with black grout. They wanted to lay a porcelain tile floor in the kitchen and replace the tub surround and floor in the hall bath. However, they wanted to be able to cook while the work was done.

In this post, they measure the rooms using the floor plan included in the listing, calculate boxes, bags and trim sticks needed and schedule the work.

The Project

House1970s single-story ranch, 8 ft ceilings, plywood subfloor over a basement
Kitchen14 × 16 ft with dinette, island, sheet vinyl
Hall bath8 × 5 ft, cast-iron tub that stays, 1970s tile on drywall
Other bathA ¾ bath off the primary bedroom, so the hall bath can be out of service
Goal12 × 24 in porcelain in the kitchen, 2 in hex on the bath floor, 4 × 12 in wall tile to about 7 ft around the tub
ApproachOwners do the tile; a plumber replaces the tub/shower valve while the wall is open

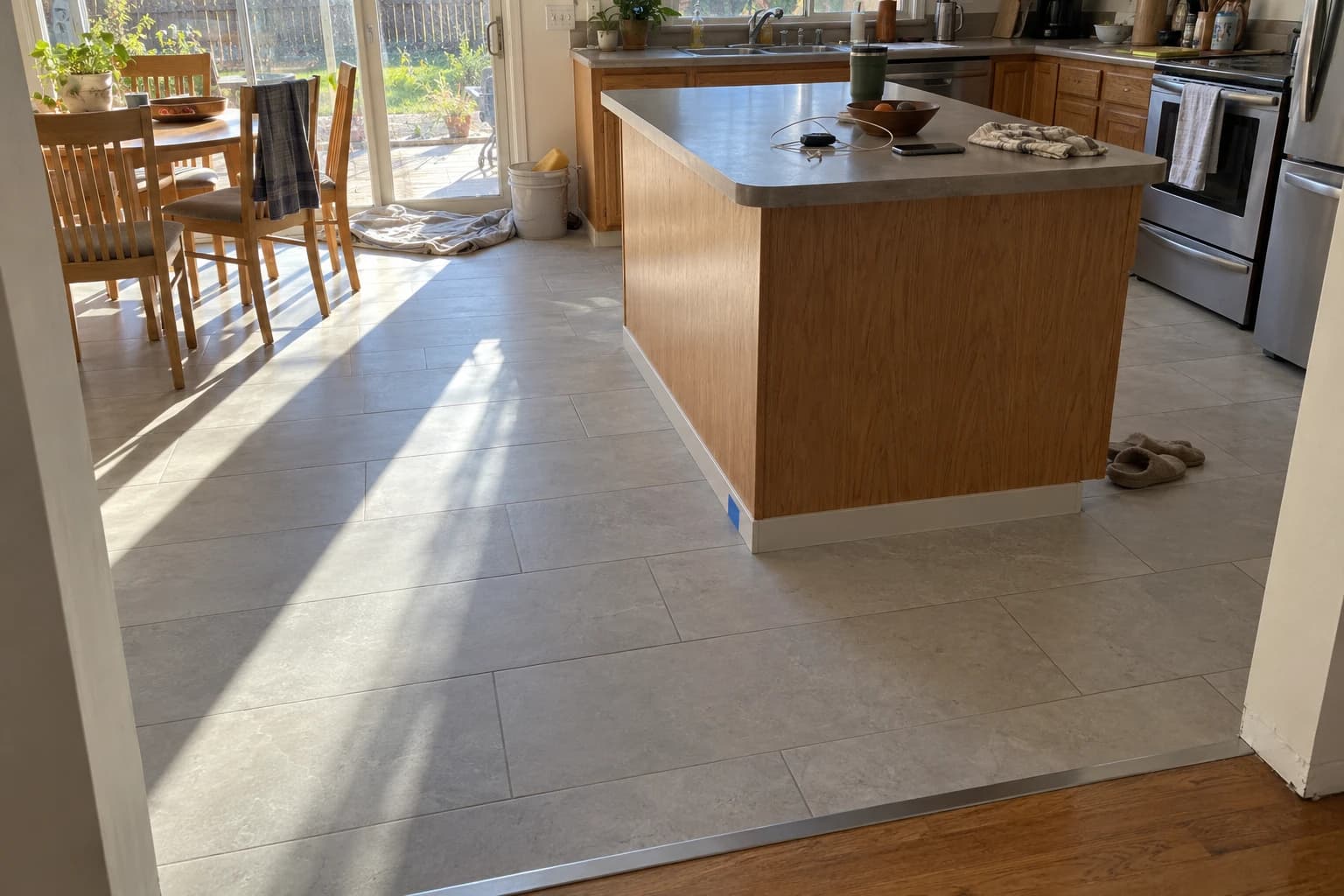

The finished kitchen floor in afternoon light: light gray 12 by 24 inch porcelain laid around the island, running to the dinette table and patio slider, with an aluminum transition strip at the hall opening

Step 1: The Listing Plan, Scaled and Checked

They happened to have the floor plan the realtor gave them when they bought the house, but it did not include any cabinets, the kitchen island or the tub. They printed it out and located and drew in the cabinets, island and tub using a 25’ tape measure. The marked-up plan was then opened in Floor Plan Calculator using the Set Scale tool and the longest wall dimension shown, the 16’ kitchen wall to the east.

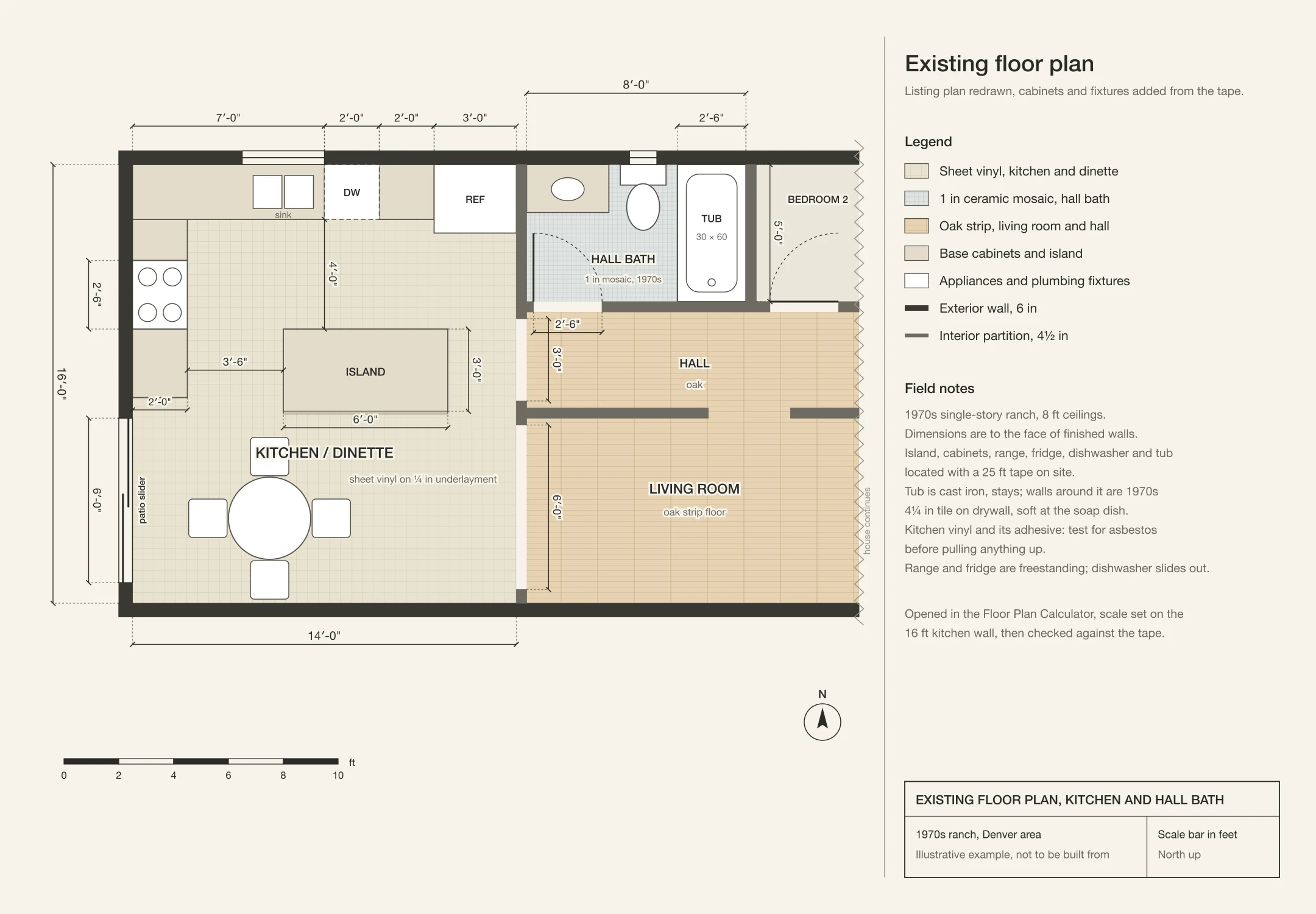

Existing floor plan of the kitchen, dinette and hall bath with cabinets, island, appliances, tub, door swings and dimensions in feet and inches

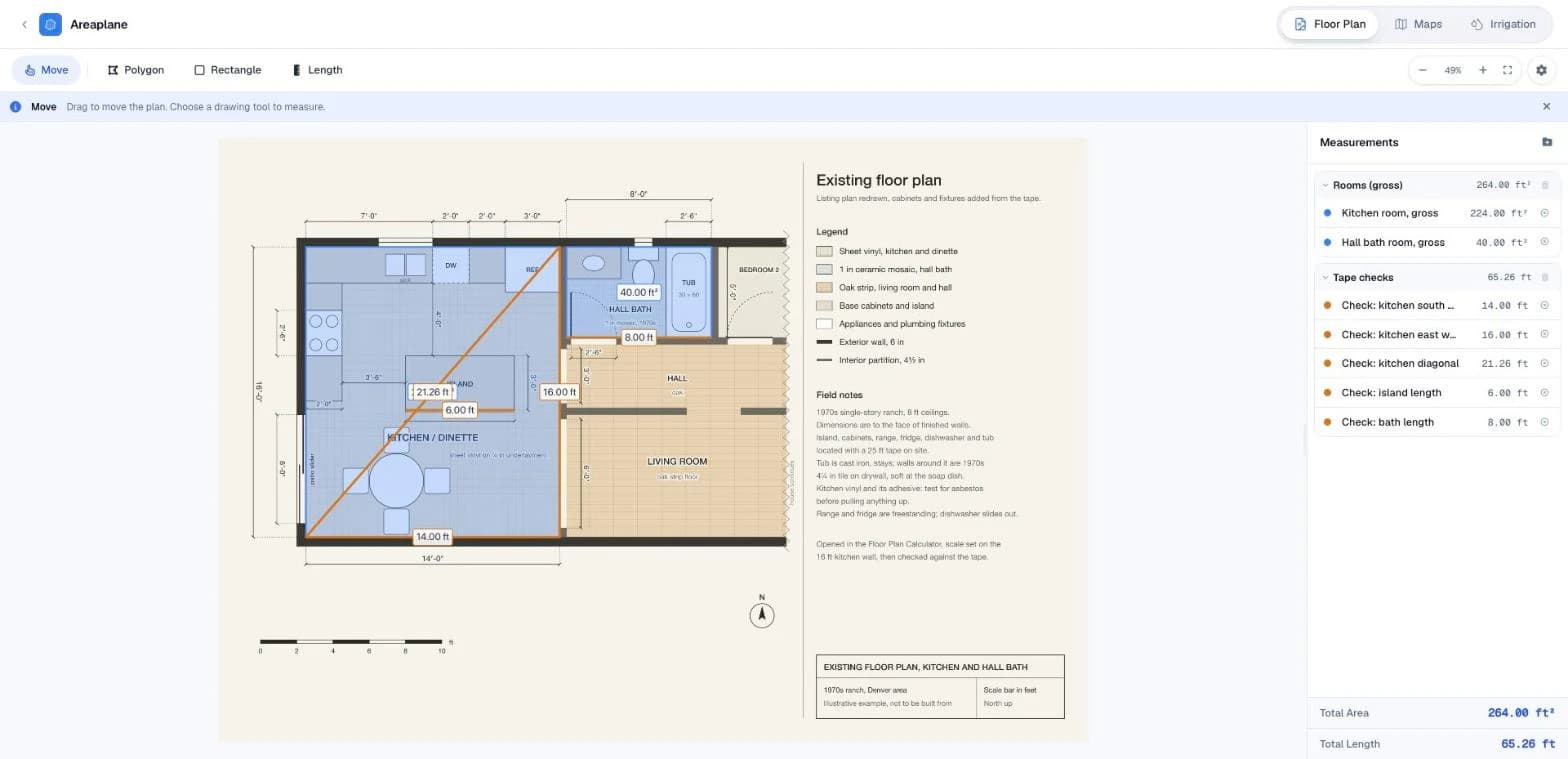

The existing floor plan loaded in Areaplane with the kitchen and hall bath traced as gross room areas and five tape-check lengths measured

Download the existing-plan project to open it in Areaplane.

They used the Length tool to check the drawing against the tape:

CheckAreaplaneTape
Kitchen south wall14.0 ft13 ft 11¾ in
Kitchen east wall (scale line)16.0 ft16 ft 0 in
Island6.0 ft6 ft 0 in
Bath, door wall8.0 ft8 ft 0¼ in
Tub back wall5.0 ft4 ft 11⅞ in
Kitchen diagonal21.26 ft21 ft 3 in and 21 ft 3½ in

It all matched up to within 1/4″. Checking the diagonals is more important for tile than for painting. The two kitchen diagonals measured 1/2″ different which, given the dimensions, means the room is only 0.11 degrees out of square or 3/8″ over the 16’ wall. That much will show up in long grout lines so they decided to snap layout lines off of the island instead of off of a wall.

The gross areas of the two rooms are 224 square feet and 40 square feet.

Step 2: The Tile Takeoff

On another sheet, they determined the areas to be tiled and traced those.

  • Under appliances, yes. They decided to tile under all appliances (range, refrigerator and dishwasher bay) for a total of 16.5 square feet so that the appliances could be pulled out at a later date. The floor will be a little higher with the new tile which is ok, but it is a common problem for people to trap the dishwasher in when they raise the floor.
  • Under cabinets and island, no. They decided not to tile under the cabinets or the island.
  • Bath wall to wall. They decided to tile wall to wall in the bathroom even under the new vanity because the new vanity has a different footprint than the old one and it will be easier to lay out the hex that way. They were not replacing the tub.

Since a polygon cannot have a hole in it (like the island in the middle of the kitchen), they split the kitchen into two polygons using the centerline of the island. Conveniently, the island centerline also divides the job into two phases.

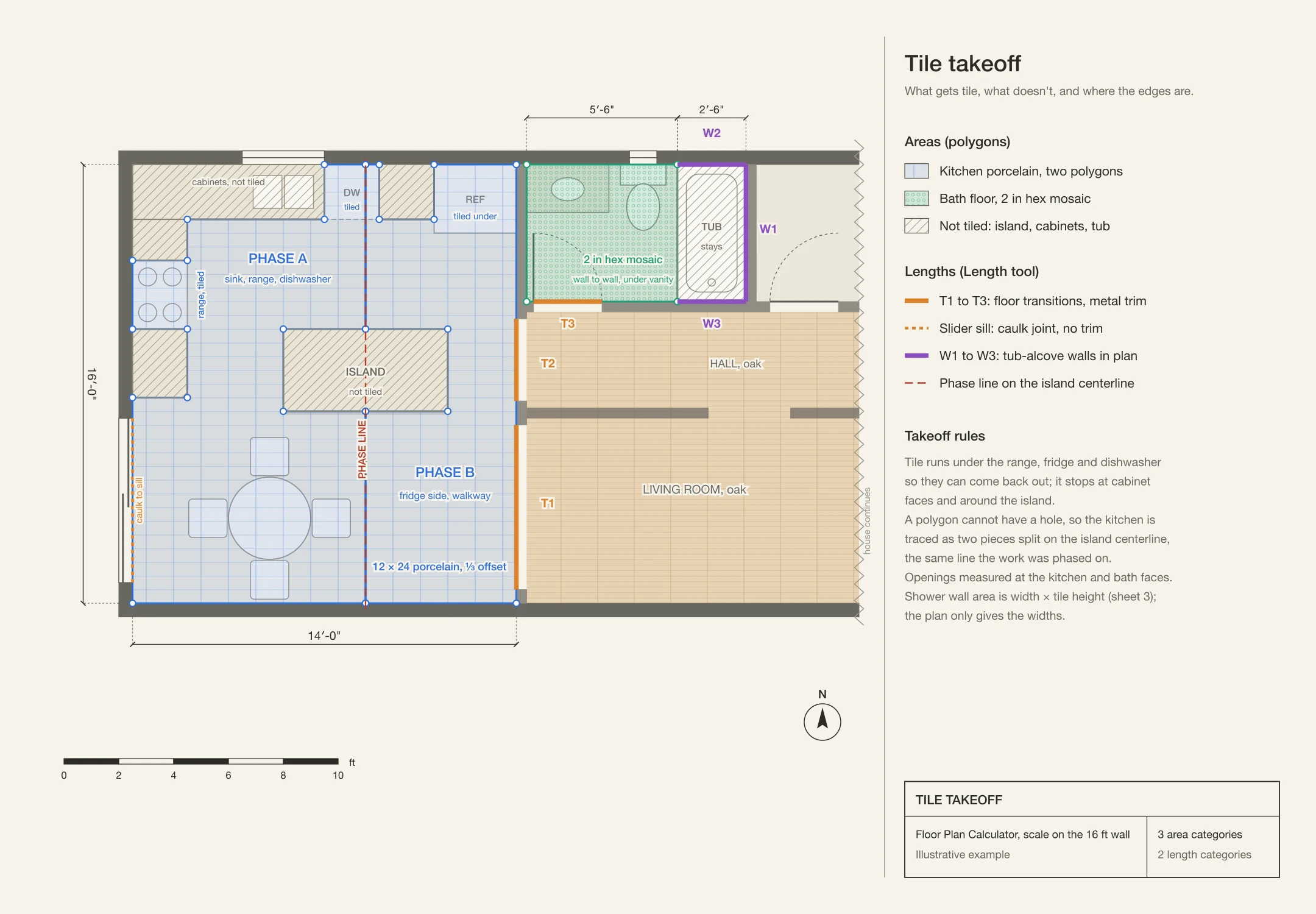

Tile takeoff sheet: kitchen porcelain in two polygons split by the phase line on the island centerline, bath hex floor, island, cabinets and tub hatched as not tiled, transitions T1 to T3 and shower walls W1 to W3 marked

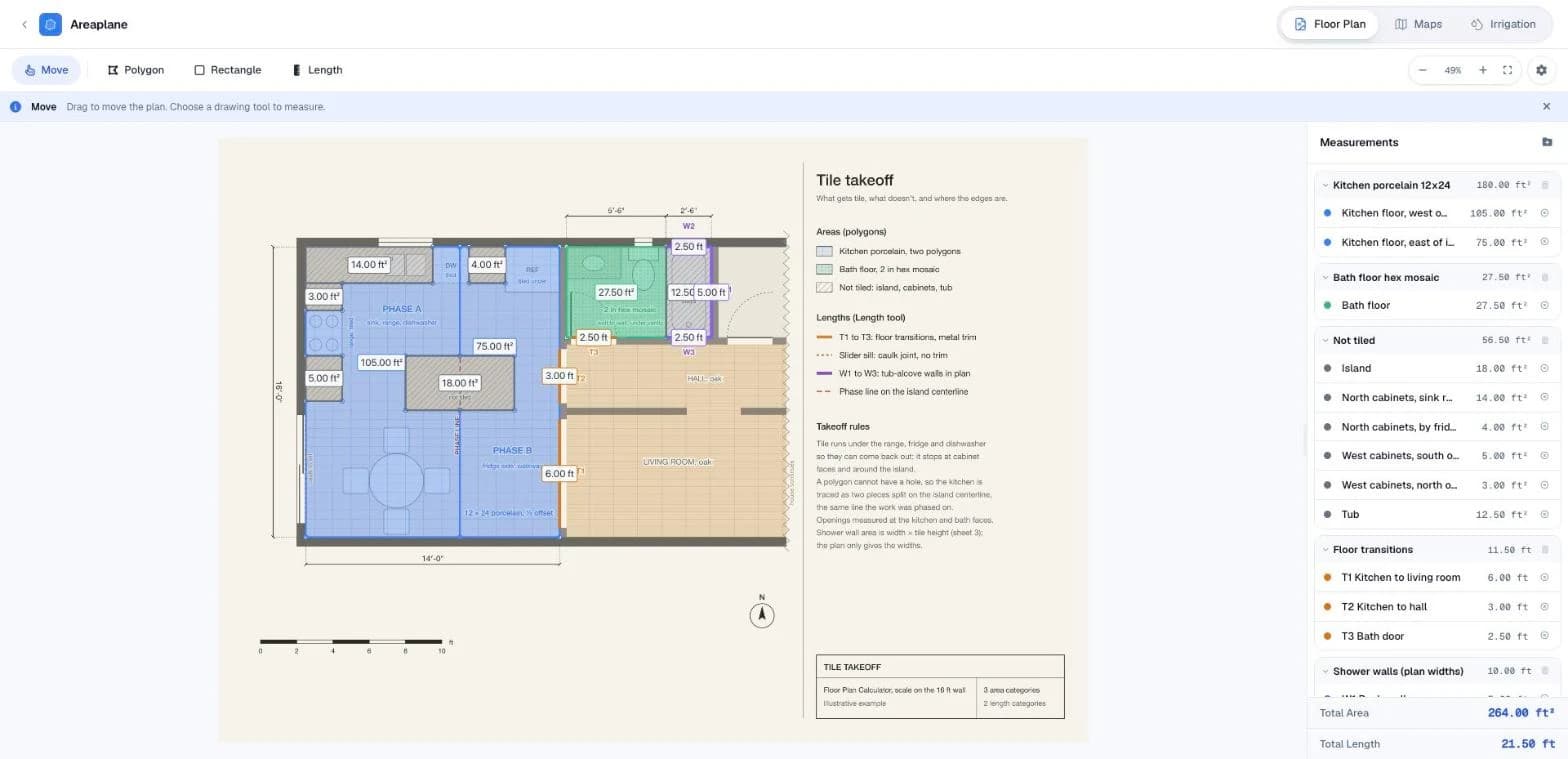

The takeoff sheet in Areaplane with the kitchen, bath and not-tiled areas in three categories and the transitions and shower wall widths measured as lengths

Download the takeoff project to see the polygons and categories.

CategoryPiecesTotal
Kitchen porcelainWest of island line 105 + east 75180 sq ft
Bath floor hexOne rectangle, 5.5 × 5 ft27.5 sq ft
Not tiledIsland 18, cabinets 26, tub 12.556.5 sq ft
Check180 + 27.5 + 56.5264 sq ft = 224 + 40 gross
Floor transitionsT1 living room 6, T2 hall 3, T3 bath door 2.511.5 ft
Tub-alcove walls in planW1 back 5, W2 and W3 ends 2.5 each10 ft

No trim is needed around the 6’ long patio slider sill since it will be a caulk joint.

Step 3: The Shower Walls

Floor Plan Calculator can only measure what is drawn on the plan and all of the walls are drawn as lines. So, to measure the area to be tiled on the tub surround, they used the widths of the walls they measured on the plan and multiplied by the height they planned to tile. To figure the height, they drew the three walls of the tub alcove out flat on yet another sheet.

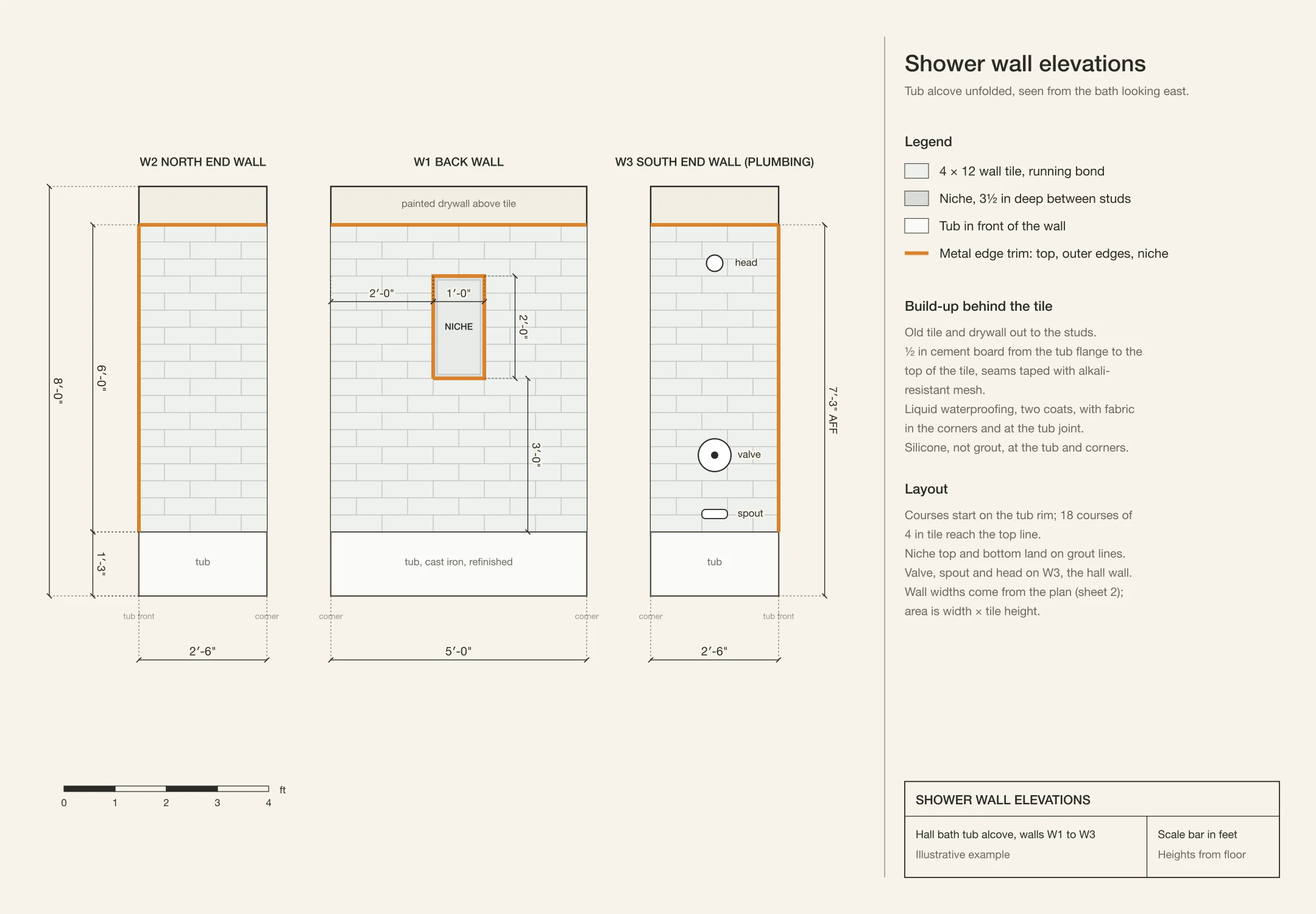

Unfolded elevations of the three tub-alcove walls: 4 by 12 inch tile from the tub rim to 7 feet 3 inches above the floor, a 1 by 2 foot niche on the back wall, the valve, spout and head on the south end wall, and edge trim along the top and outer edges

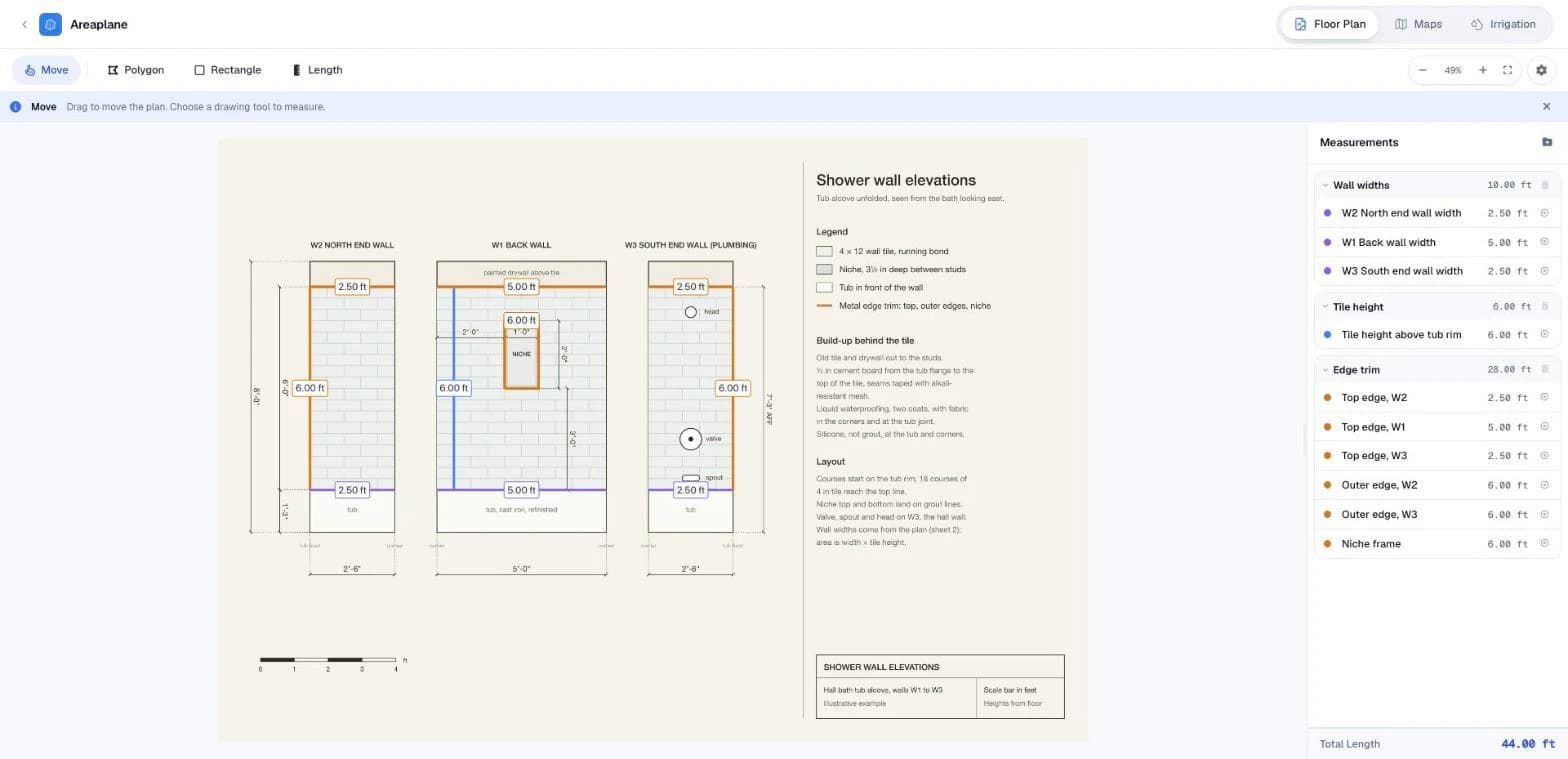

The shower elevation sheet in Areaplane with wall widths, the tile height and the edge trim runs measured as lengths

Download the elevation project to check the lengths.

The courses are stepped off from the tub rim, which is 15″ off the floor. 18 courses of 4″ tile is 6 ft, so the top of the wall is 7’-3″ off the floor, a few inches above the shower head. The shower niche is sized to have grout lines at top and bottom.

WallWidthTile heightArea
W2 north end2.5 ft6 ft15 sq ft
W1 back5 ft6 ft30 sq ft
W3 south end, plumbing2.5 ft6 ft15 sq ft
Niche returns2 × (1 + 2) ft perimeter3.5 in deep1.75 sq ft
Total wall tile61.75 sq ft

Note that the back of the niche is already included in the area of the back wall, so just the four returns are added.

Step 4: Turning Areas into Orders

Tile and waste by layout

The percent of waste varies with the layout: least for straight lays, a little more for offset, and the most for diagonal. For large format tile, where one side of the tile is 15″ or more, add about 5 points to the waste percent, because every time you cut a tile, you have a big piece that may not fit somewhere else. The reason that large format tile, over 18″ long, should be offset no more than 1/3, is that tiles this long are rarely perfectly flat. With a 1/2 offset, the high part of the middle of one tile would be butted against the low part of the ends of the adjacent tiles.

Kitchen layout, 180 sq ftAllowanceNeedBoxes of 15.5 sq ft
Straight (stacked)10% + 5% large format = 15%207 sq ft14
⅓ offset12% + 5% = 17%210.6 sq ft14
Diagonal18% + 5% = 23%221.4 sq ft15

In this case, the offset didn’t cost anything, so why not? In any case, enough boxes were ordered to get 217 sq ft of tile – 14 boxes, or 112 pieces, which is 20.6% more than the net area. The extra tile will be stored in the basement in case any tiles need to be replaced in the future. It’s important that the extra tile come from the same production lot, since there can be slight variations in color and thickness from one lot to the next.

TileNetAllowanceNeedUnit of saleBought
2 in hex, bath floor27.5 sq ft15% (toilet flange, small room)31.6 sq ftSheets of 0.94 sq ft34 sheets (32.0 sq ft)
4 × 12 wall tile61.75 sq ft12% (niche, valve cuts)69.2 sq ftBoxes of 10 sq ft7 boxes (70 sq ft)

What goes under the tile

ItemBasisQuantity
Uncoupling membrane, kitchen180 sq ft + 10% for seams = 198 sq ftOne 175 + one 54 sq ft roll
¼ in cement board, bath floor27.5 sq ft; two 3 × 5 sheets cover 6 × 5 ft2 sheets
½ in cement board, tub wallsBack wall 2 sheets laid flat; each end 1 sheet stood up; 1 sheet ripped for the top strips5 sheets, bought 6
Liquid waterproofing61.75 sq ft at 55 sq ft per gallon, two coats2 gallons, plus corner fabric

The membrane will go on the existing plywood subfloor after the vinyl has been removed. Before ordering the membrane, the vinyl and the glue under the vinyl were tested for asbestos, since a lot of the floors from that era have vinyl with asbestos. This one didn’t, but if yours does, you need to do some googling to find out the rules for your state.

Two other things to check before ordering the membrane: is the floor stiff enough for porcelain tile, which requires L/360, and what will the finished height be with the membrane, thinset and 3/8″ tile? From down in the basement, it looks like the joists are 2×10 at 16″ on center, spanning about 13 ft. Checking a span table, it looks OK with a little bit of margin, and the subfloor will be screwed down again at 6″ on center to the joists. The 3/8″ tile, plus thinset and membrane, will add about 3/4″ to the floor height, which is about the same as the oak flooring in the living room and hall, so a flush transition can be used at T1 to T3 instead of a ramped reducer.

Thinset by trowel

The square feet per 50 lb bag can be found on the bag – use the chart for the size trowel you’ll be using. It will be a lot more for a larger size trowel.

UseTrowelSq ft per bagAreaBags
Membrane to plywood¼ × 3/16 in V1001801.8 → 2 unmodified
12 × 24 tile on membrane½ × ½ in square, back-buttered401804.5 → 5 large-format
¼ in board, bath floor¼ × ¼ in square9027.50.31
2 in hex sheets3/16 in V10027.50.28
4 × 12 wall tile¼ × ¼ in square9061.750.69
Bath subtotal1.28 → 2 modified

Note: you need to use whatever thinset is specified by the membrane/waterproofing manufacturer.

Grout by joint and tile size

Pounds per sq ft = (L + W) ÷ (L × W) × joint width × tile thickness ÷ 12 × weight, where L, W are in inches, and the weight is 116 lb/cu ft. Note that the amount of grout per square foot is a lot more for smaller tile, since there’s a lot more square feet of joints per sq ft of floor. In this case, there’s over 2.5 times as much grout per sq ft for the hex tile as for the 12×24.

AreaTile, joint, depthlb per sq ftlb+25%Bought
Kitchen12 × 24, ⅛ in, ⅜ in0.05710.212.7One 25 lb bag
Bath floor, dark gray2 in hex, 1/16 in, ¼ in0.1514.25.2One 10 lb box
Tub walls, white4 × 12, 1/16 in, 5/16 in0.0633.94.9One 10 lb box

Edge trim, measured with the Length tool

The trim comes in 8.2 ft (2.5 m) long sticks, and each run has to be a single piece.

TrimRuns (ft)TotalSticks, as cut
Flush transition, tile to oak6, 3, 2.511.5 ft2: 6; 3 + 2.5
Shower edgeTops 2.5, 5, 2.5; outer edges 6, 6; niche 1, 1, 2, 228 ft4: 6 + 2; 6 + 2; 5 + 2.5; 2.5 + 1 + 1

Step 5: A Schedule Around a Working Kitchen

Since there’s another shower in the house, the bathroom was done first. The kitchen will be done in two halves, using the line down the middle of the island as the dividing line. Half “A”, with the sink, range and dishwasher, is 105 sq ft, and half “B”, with the refrigerator and the walkway to the living room, is 75 sq ft. Either half can be used while the other half is being done.

It’s not so much the time required to do the work, but the cure times between the steps. The bags say 24 hours before light foot traffic, and then the floor can be grouted, and the appliances put back on about 72 hours after the grout is done. That means each half of the kitchen will take a weekend and most of the following week to do, even though it only took one long day to set the 105 sq ft of half “A”. For the bathroom, the waterproofing had to cure completely before the tile could be set, and the silicone had to cure for a day before the shower could be used.

Dates (2026)Work
Jul 11Listing plan scaled, tape check, takeoff
Jul 13–17Vinyl and adhesive samples to a lab: none detected
Jul 18Tile, membrane, board and trim ordered; plumber booked
Aug 1–2Bath demo to the studs and subfloor; soft plywood patched at the toilet
Aug 4Plumber replaces the tub/shower valve
Aug 8–9Cement board on walls and floor, niche framed, seams taped
Aug 10–12, eveningsWaterproofing, two coats, cured
Aug 15–16Wall tile; grout Aug 18
Aug 22–23Hex floor, then grout
Aug 29Silicone, toilet, vanity, trim; bath back in use
Sep 5–7 (Labor Day)Phase A: vinyl up, membrane, tile to a stepped edge at the island line
Sep 9Phase A grout; range and dishwasher back Sep 11
Sep 12–13Phase B: fridge to the living room, vinyl, membrane, tile
Sep 15Phase B grout
Sep 19Transitions, base trim, fridge back; grout sealed a week later

Where the tile meets the island, there's a "stop" edge that follows the stepped line of the ends of the tile. This was done by scraping the thinset back to the stop-edge after the tile was laid, but before the thinset set. Phase A was the microwave and a new induction cooktop on a folding table in the living room with dishes washed in the bath. Phase B had a sink and range, with the refrigerator on a piece of cardboard in the living room for a week.

The Final Numbers

LineEstimateFinal
Kitchen porcelain, 14 boxes$673$673
Bath hex, 34 sheets$336$336
Wall tile, 7 boxes$298$322
Uncoupling membrane, 2 rolls$470$470
Cement board, screws, mesh tape$178$178
Waterproofing and fabric$164$164
Thinset, 9 bags$276$276
Grout, silicone, sealer$141$141
Edge trim, 6 sticks$200$200
Asbestos test$100$100
Subfloor patch at the toilet$0$65
Plumber, new valve$650$780
Tools: rail cutter, wet saw, leveling clips, trowels$575$575
Disposal, protection, temporary-kitchen supplies$200$215
Total$4,261$4,495

The finished cost was $234 over, or 5.5%, due to a $0.35/sf increase in wall tile, extra work for the valve, and patching a piece of subfloor not included in the original plan. There was no error in quantities, although there is a box of porcelain tile, four sheets of hex tile and most of a box of wall tile remaining.

A quote for the tile setting came in at $8,340 for labor. Breaking it out, it was $1350 demo, $2340 kitchen @ $13/sf, $950 bath floor, $3400 surround, and $300 for trim. With the same $2,760 in materials, the test, and the plumber, the total cost for that bid would have been $11,980. Aside from the savings of ~$7500, which was the primary motivation for this project, the waiting time for the tile setter was six weeks. This project required five weekends and a lot of evenings.

Although the quote wasn't used, it provided an excellent check on the quantities in the takeoff, since the items were almost exactly the same. If the subfloor had needed to be rebuilt, or the room had been far out of square, it would have been necessary to use the tile setter for the kitchen part of the job and do just the bath themselves.

What They Would Do Differently

  • Be sure to measure the diagonals before buying tile. In this case, the 3/8" didn't matter, but it could have.
  • Order the asbestos test as soon as it's known that a remodel is wanted. This was the only week in the project that nothing was done.
  • Open up the wall before calling the plumber, to see if a new valve body is needed, rather than a cartridge. This one needed a new body.
  • Keep all of the files, in case a replacement tile is needed at some time in the future. The takeoff will tell you exactly what is needed.

Use This on Your Own Tile Project

  1. Open the listing's or your own drawn plan in Floor Plan Calculator. Set the scale using the longest dimension and check the length of three or four other dimensions, as well as a diagonal, to make sure that the scale is correct, using your tape measure.
  2. Decide where tile will be used, such as under free-standing appliances, but not under cabinets. Trace around only the areas that will be tiled. If there is an island in the room, trace the areas separately, since a polygon cannot have a hole in it.
  3. Separately record the areas to be tiled, the areas not to be tiled, and the length of trim. The tiled and not-tiled areas should add up to the entire room.
  4. Measure the walls by the width and the height that the tile will be set. This should be a whole number of courses.
  5. Decide on the layout of the tiles before estimating the amount of waste. A higher percentage of waste may be needed if large format tiles are used.
  6. Estimate the thinset from the trowel size chart and the grout from the width of the joints and the size of the tiles. These should be rounded up to the amount sold.
  7. Make a phasing plan for a working kitchen along one of the traced lines.

For more, see how to measure square footage from a floor plan and how to measure an irregular room.
